Date of Notice Period Of Work Time Of Work  Location  Craft  Contacts

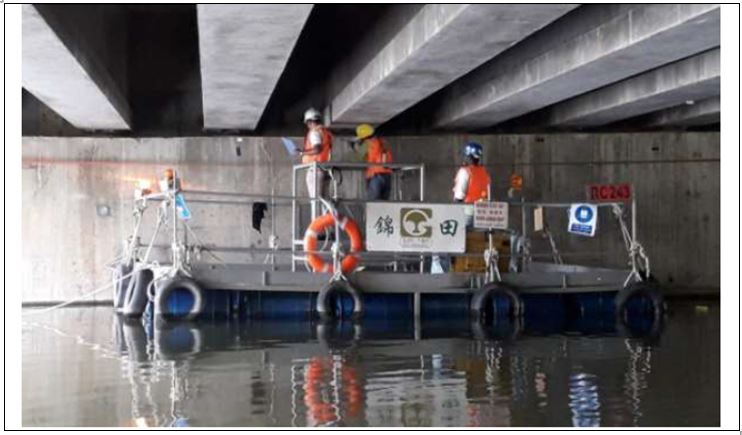

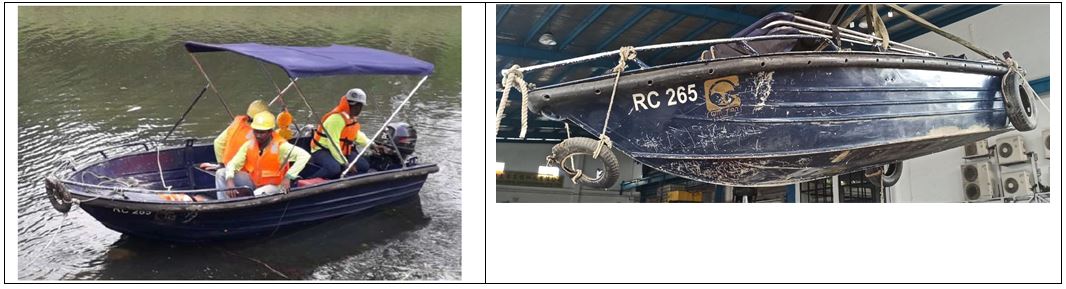

17 March 20223 20 March to 22 April 2023 0830 hrs to 1800 hrs Eu Tong Sen Street/ Coleman Bridge  RC265 Work Boat, RC243 Floating Pontoon made of PVC drums  Selvaraj Raja 8189 17948189 1794 ([email protected]);
Lee Ik Wen 9721 36239721 3623 ([email protected])

Bridge Works

After completion of daily work, the pontoon and work boat will be anchorage at bridge abutment wall. Towing only happens within work zone. All vessels are advised to keep clear of the repair work areas and slow down when in the vicinity.

Gim Tian Civil Engineering Pte Ltd has been engaged by LTA to carry out concrete repair work to vehicular bridge at Eu Tong Sen Street/ Coleman Bridge from 20 March 2023 to 22 April 2023. Please refer to the table below for the schedule of works and activities.

Activities Start Date/Time End Date/Time
Mobilisation of pontoon and work boat 20 Mar 2023 / 2330hrs 21 Mar 2023 / 0430hrs
Concrete repair works 21 Mar 2023 / 0830hrs 21 Apr 2023 / 1800hrs
De-mobilisation of pontoon and work boat
21 Apr 2023 / 2330hrs 22 Apr 2023 / 0430hrs.

During working day, RC 243 pontoon will be pushed by RC 265 work boat towards the repair locations underneath of bridge.

Gim Tian Civil Engineering Pte Ltd has been engaged by LTA to carry out concrete repair work to vehicular bridge at Eu Tong Sen Street/ Coleman Bridge from 20 March 2023 to 22 April 2023. Please refer to the table below for the schedule of works and activities.

Activities Start Date/Time End Date/Time
Mobilisation of pontoon and work boat 20 Mar 2023 / 2330hrs 21 Mar 2023 / 0430hrs
Concrete repair works 21 Mar 2023 / 0830hrs 21 Apr 2023 / 1800hrs
De-mobilisation of pontoon and work boat
21 Apr 2023 / 2330hrs 22 Apr 2023 / 0430hrs.

During working day, RC 243 pontoon will be pushed by RC 265 work boat towards the repair locations underneath of bridge.
