RESERVOIR NOTICE

Pontoon installation and removal works for PW50th Celebratory Events



Date of Notice

22 August 2024

Period of Work

22 August to 5 October 2024

(Refer to schedule below)

Time

0700hrs to 1900hrs

Location

Marina Reservoir (Kallang Basin, Marina Channel and Marina Bay)

Craft

RZ57

RZ92

Contact Person

PAssion Wave @ Marina Bay

S Dharma

[email protected]



Intermay Consultech Pte Ltd

Samson Phua

[email protected]



Roy Lim

[email protected]





1.    There will be installation and removal works in Kallang Basin and Marina Bay from 22 August 2024 to 5 October 2024. Please refer to the table below for the schedule of works and activities and the location maps.



2.    All vessels are to comply with the instructions/ directions given by the safety/work boats’ crew.



Date

Time

Activities

Safety Remarks

22 August 2024 to

25 August 2024

0700hrs to 1900hrs

Configuration of cubis and

pontoons at Kallang basin

(Republic Ave)

All vessels are to keep

clear of setup areas

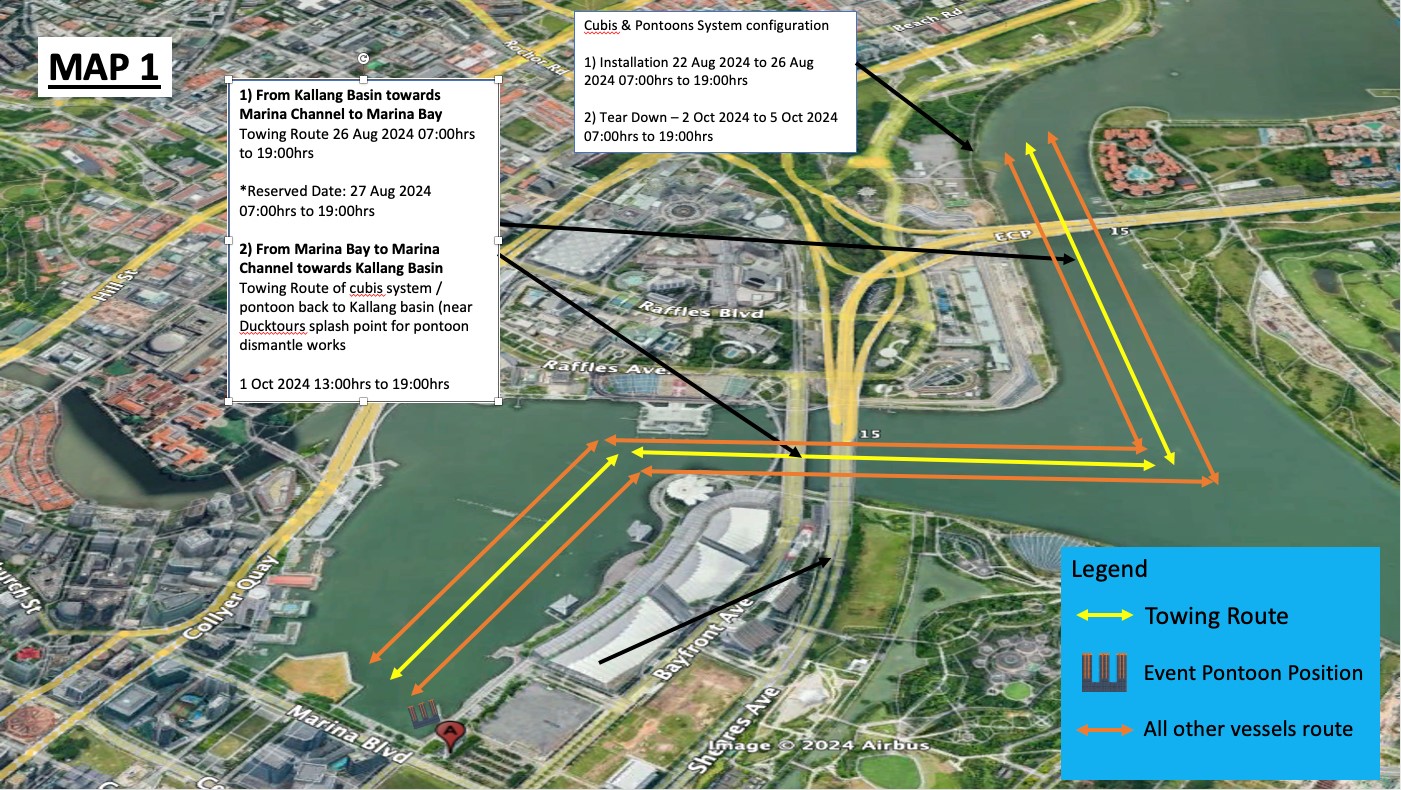

(Refer to Map 1)

26 August 2024

(*Reserved Date 27

August 2024)

0700hrs to 1900hrs

Towing of pontoons/cubi

system from kallang basin

(Republic Ave) to Marina

bay for positioning and

anchoring



*Reserved date for towing

ops

All vessels are to keep

wide berth to the towing

operations and keep

clear of set up areas.

(Refer to Map 1)

27 August 2024 to

4 September 2024

0700hrs to 1900hrs

Setting up for event

All vessels are to keep

clear of setup areas

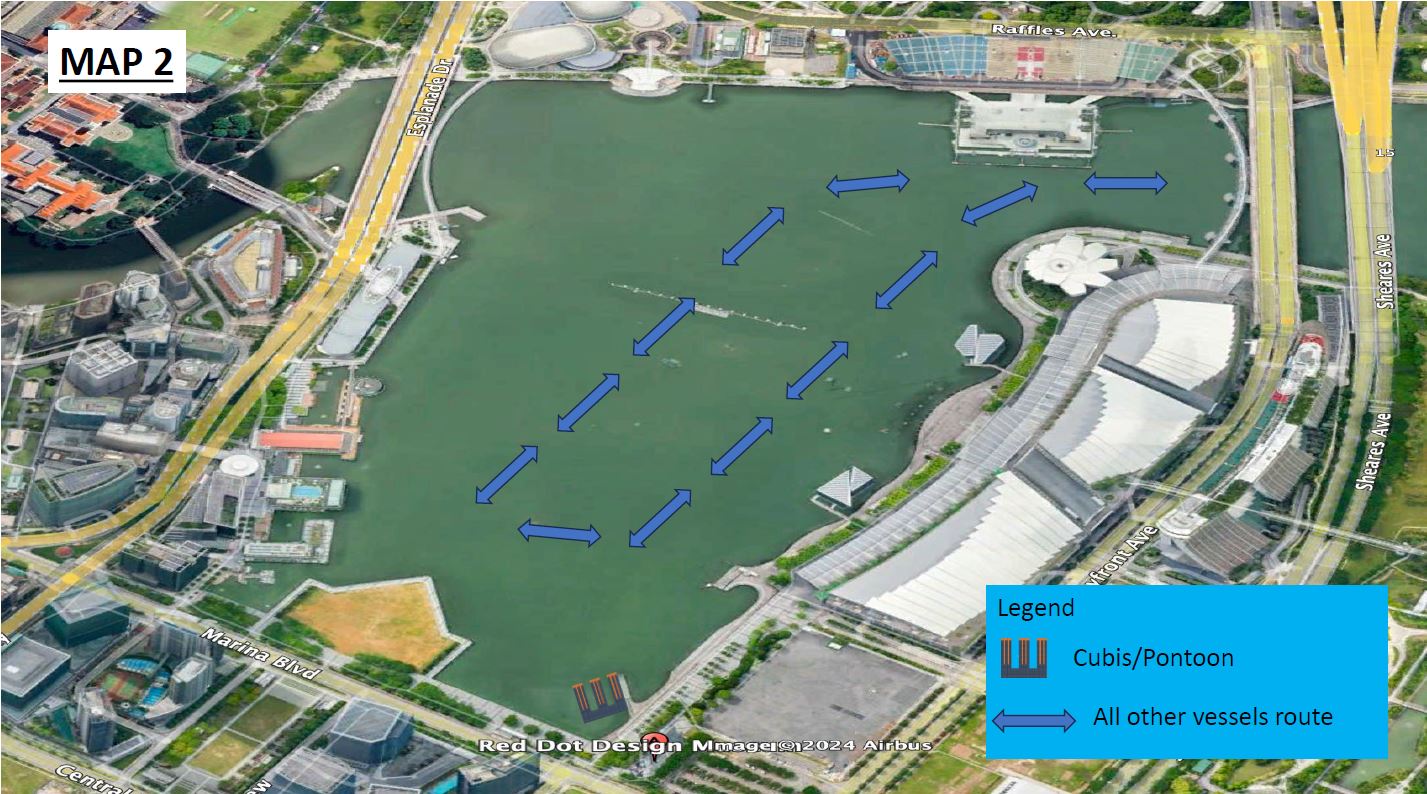

(Refer to Map 2)

05 September 2024

to 1 October 2024

0700hrs to 1900hrs

Event activities period

All vessels are to keep

clear of the event area

(Refer to Map 2)

1 October 2024



1300hrs to 1900hrs

Towing of pontoons/cubi

system from Marina

Channel back to Kallang

Basin (Republic Ave) for

pontoon dismantle works

All vessels are to keep

wide berth to the towing

operations and keep

clear of set up areas.

(Refer to Map 1)

2 October 2024 to 5

October 2024

0700hrs to 1900hrs

Pontoon dismantle works.

Craning operation to

remove pontoon/cubis

system back to storage

All vessels are to keep

clear of tear down areas.

(Refer to Map 1)
