Date of Notice |
19 May 2026 |
|
Period Of Works |
09 Feb 2026 to 08 Nov 2028 |
|
Location |
Garden by the Bay @ Marina Reservoir |
|
Crafts |
SR3554H (Crane Barge), SR4007Z (Crane Barge), RC583 (Crane Barge), RC413 (Tug Boat), RC 416 (Work Boat),RC493 (Material barge), RC494 (Material Barge) |
|
Time |
0000 hrs- 2359 hrs |
|
Contact |
Quinn Yeo @ 8282 3866; Terrence Chan @ 9854 9555 (MTC) |
Expand Construction Pte Ltd is appointed by Garden by the Bay to construct South East Bridge at Marina Reservoir. Marina Technology and Construction Pte Ltd (MTC) is the appointed Marine Specialist for the Marine Works. The Works will include the installation of piling, temporary cofferdam to construct pilecap, erection of bridge, construct concrete pontoon and connecting access bridge to pontoon & its associated construction equipment/plants.
Table 1 shows the Construction Project Schedule.

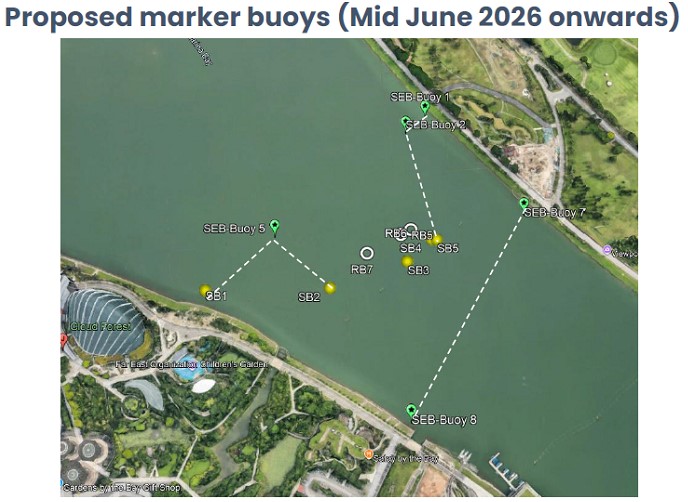

Refer to the attached drawing Figure 1 for the Master Site Plan. The limits of the construction boundaries, where vessels are required to keep clear, are defined by Navigation Buoys with respective navigation lights at SEB-Buoy 1, Buoy 2, Buoy 3 (replaced with SB5), Buoy 4 (Replaced with SB2), Buoy 5, Buoy 6 (Replaced with SB1), Buoy 7 & Buoy 8 at Working Area A located at site location as shown Figure 2, and TOL-Buoy A, Buoy B, Buoy C and Buoy D at Working Area B as shown on Figure 3, marine launch located at Republic Ave
All vessels are advised to keep clear of the construction boundaries and reduce to a speed of 5 knots while passing through the Temporary Navigation Buoys during the project duration.
Table 1
Construction Project Schedule
|
Start Date |
End Date |
Work Description |
|
Month 1 (9 Feb 2026) |
Month 3 (8 May 2026) |
Mobilise machinery, plants and equipment, marine boreholes, and marine survey works |
|
Month 3 (23 May 2026) |
Month 14 (8 Mar 2027) |
Installation of piling and construction foundation pilecap |
|
Month 12 (8 Jan 2027) |
Month 23 (31 Dec 2027) |
Erection of bridge structure |
|
Month 24 (2 Jan 2028) |
Month 29 (26 Jun 2028) |
Connecting pontoon and gangway from bridge to East Bay |
|
Month 24 (2 Jan 2028) |
Month 32 (8 Oct 2028) |
Architectural items, Landscape and M&E Works |
|
Month 32 (8 Oct 2028) |
Month 33 (8 Nov 2028) |
De -mobilise machinery, plants and equipment |
Table 2
Construction Work Boundary
Working Area A (Main Construction Site)
|
Coordinates |
Buoy Characteristics |
Light Characteristics |
|||||
|
Stn |
E |
N |
Lat |
Long |
|||
|
SEB |
Buoy 1 |
32084.908 |
29839.2922 |
1°17'10.05"N |
103°52'12.08"E |
Yellow |
Yellow Light with Flash |
|
SEB |
Buoy 2 |
32055.616 |
29819.1213 |
1°17'9.39"N |
103°52'11.14"E |
0.5 Sec on, 1.0 Sec off |
|
|
SEB |
SB5 |
32079.961 |
29662.8941 |
1°17'4.3"N |
103°52'11.92"E |
||
|
SEB |
SB2 |
31933.770 |
29610.989 |
1°17'2.61"N |
103°52'7.19"E |
||
|
SEB |
Buoy 5 |
31866.408 |
29688.9838 |
1°17'5.15"N |
103°52'5.02"E |
||
|
SEB |
SB1 |
31771.499 |
29623.477 |
1°17'3.02"N |
103°52'1.95"E |
||
|
SEB |
Buoy 7 |
32195.113 |
29710.0195 |
1°17'5.84"N |
103°52'15.65"E |
||
|
SEB |
Buoy 8 |
32199.503 |
29686.985 |
1°16'56.77"N |
103°52'9.95"E |
||
Working Area B (Marine Launching Site)
|
Coordinates |
Buoy Characteristics |
Light Characteristics |
|||||
|
Stn |
E |
N |
Lat |
Long |
|||
|
TOL |
Buoy A |
31597.271 |
31290.005 |
1°17'57.30"N |
103°51'56.31"E |
Yellow |
Yellow Light with Flash |
|
TOL |
Buoy B |
31504.53 |
31157.007 |
1°17'52.97"N |
103°51'53.31"E |
0.5 Sec on, 1.0 Sec off |
|
|
TOL |
Buoy C |
31494.409 |
31142.493 |
1°17'52.48"N |
103°51'52.98"E |
||
|
TOL |
Buoy D |
31606.854 |
31318.571 |
1°17'58.23"N |
103°51'56.62"E |
||

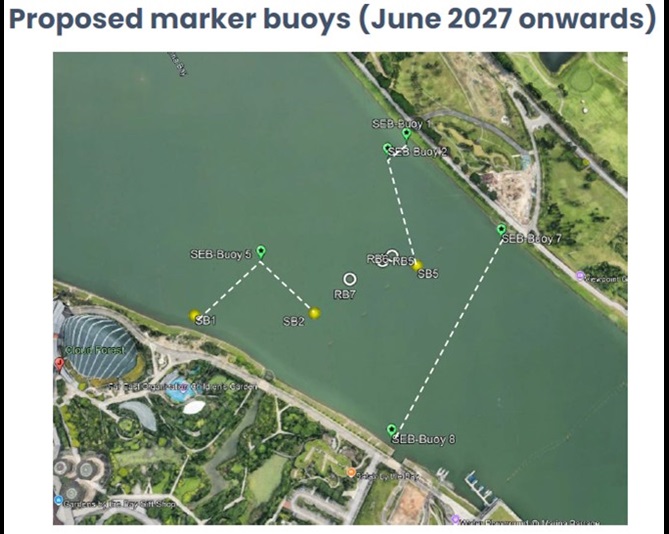

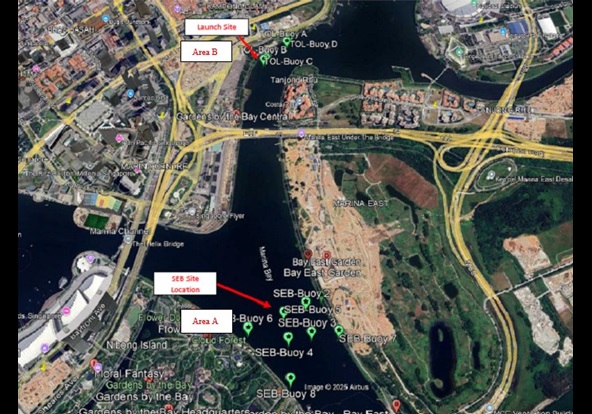

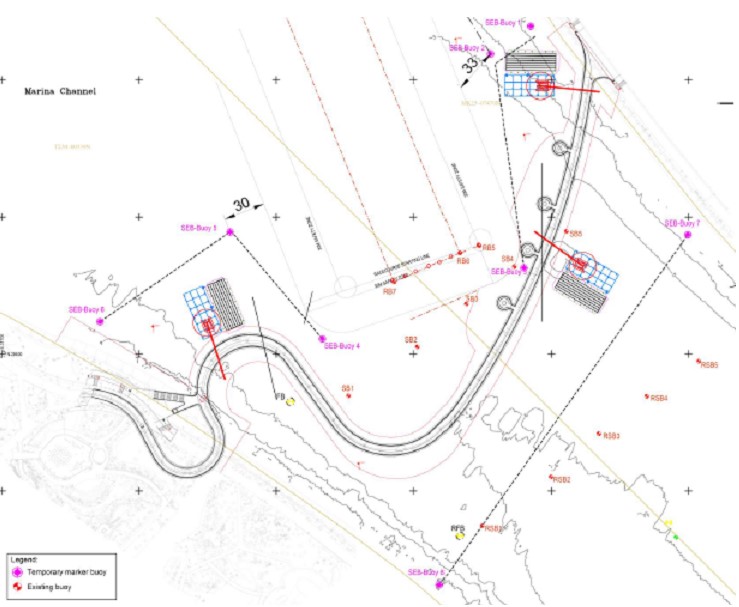

Figure 1 (Master Site Plan)
Location Plan of Working Area A & B

Figure 2 (Blown Up)
Working Area A – Main Construction Site

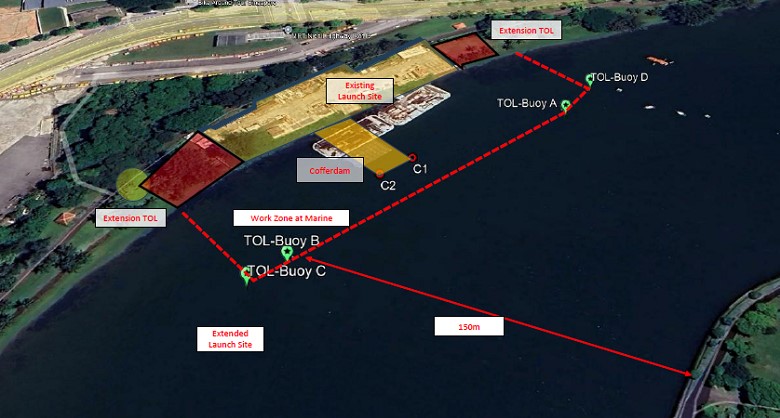

Figure 3 (Blown Up)

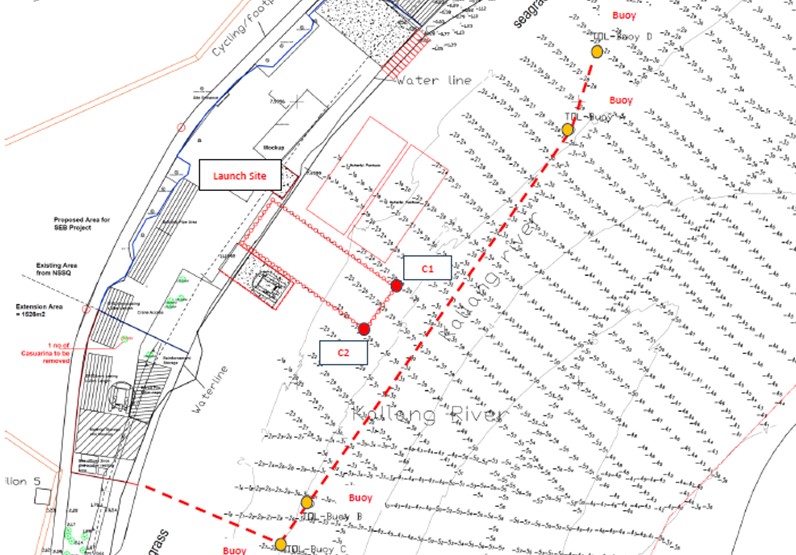

Working Area B - Marine Launch Site
|
![]() |
|

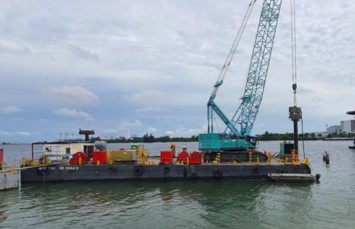

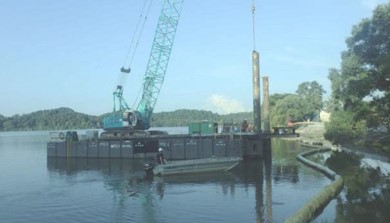

SR 4007Z |
SR3554H |
|
![]() |
|

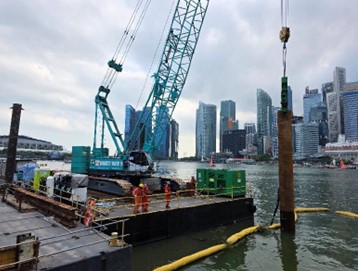

RC583 |

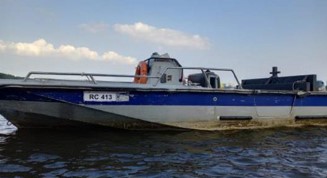

RC 413 |
![]() |
|
|

RC 416 |

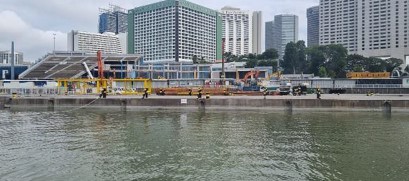

RC493 |
|
|
|

RC494 |
|
